The Turbine, Not the Interconnection Queue, Now Gates 2028 Gas
For developers planning 2027-2028 gas builds and infra funds valuing gas platforms: GE Vernova's Q1 disclosures reprice equipment risk.
For developers · For infra funds · equipment · gas-turbines · ge-vernova · deliverability
Kris Narayanan · Tafel Power · April 24, 2026 · 2 min read
The interconnection queue is one gate on firm-gas delivery. The turbine order book is the other, and GE Vernova's Q1 2026 disclosures show it tightening fast.

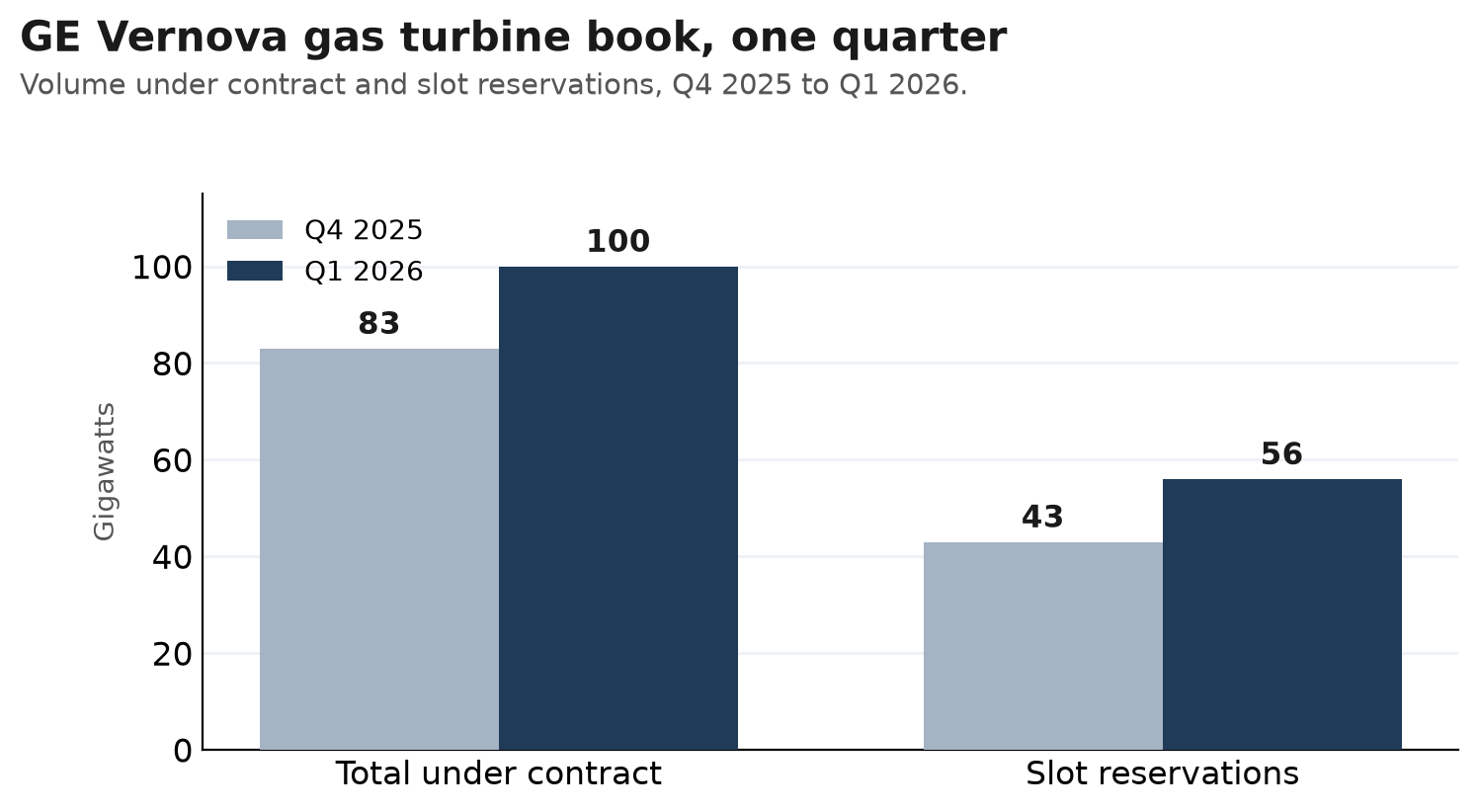

In the quarter, GE Vernova signed 21 GW of new gas equipment agreements. Its combined equipment backlog and slot reservation agreements grew from 83 GW to 100 GW, and slot reservation agreements alone rose from 43 GW to 56 GW. The company expects new 2026 orders to price 10 to 20 percent higher per kilowatt than Q4 2025 orders. GE Vernova reported broad global demand across utilities, independent power producers, industrial customers, and data centers. About 20 percent of its 100 GW under contract explicitly supported data centers.

Why this gates the deal
A signed interconnection agreement does not put steel on the ground; the turbine is what does. When slot reservations rise 13 GW in a single quarter and new order pricing moves up 10 to 20 percent, the equipment queue becomes a second binding constraint on 2027 and 2028 delivery, alongside the interconnection process rather than after it.
Developers planning 2027-2028 gas builds. A secured turbine slot is now a distinct and rising source of value, separate from the queue position. Slot-secured, equipment-backed capacity now commands a premium in firm-power deals targeting 2027 to 2028 delivery.
Infra funds valuing gas platforms. Delivery certainty depends on whether the counterparty holds equipment, not just an interconnection agreement. Equipment risk has moved from a footnote in the underwrite to a primary variable for 2027 and 2028 delivery, and it is moving against buyers.
Methodology
Figures are from GE Vernova's first quarter 2026 earnings release and the accompanying Form 8-K, filed with the SEC on April 22, 2026: 21 GW of new gas equipment agreements signed in the quarter, combined equipment backlog and slot reservation agreements rising from 83 GW to 100 GW, slot reservation agreements rising from 43 GW to 56 GW, and new 2026 orders expected to price 10 to 20 percent higher per kilowatt than Q4 2025 orders. Figures reflect the Q1 2026 reporting period.
Questions, corrections or disagreement on any of this are welcome: kris@tafelpower.com
